All Resources
Use case

Real-Time Detection and Reporting of Hydropower Generation Events

Pablo Sanchez
Industry Principal
•
Reading time:
Watch time:
2
min.
•
Updated:
Watch time:
October 9, 2026

The Challenge

Hydropower units operate under different modes depending on AGC (Automatic Generation Control) status and complementary services configuration.

Without automated classification, obtaining a clear operational overview and summarizing events and operating hours required significant manual effort.

  • Multiple operating modes and turbine configurations
  • Operating states derived from several signals
  • No consolidated real-time overview
  • Manual event and operating-hour reporting
  • Operational anomalies difficult to summarize

‍

The Approach

Engineers combined value-based searches, dashboards and AI-assisted analysis to automatically detect and summarize operating conditions.

State definition: Value-based searches defined hydropower unit generation states, based on AGC and complementary services configuration.

Event tracking: Conditions were automatically classified and tracked over time

Real-time overview: A Gantt chart consolidated all states in the main dashboard

AI-assisted analysis: TrendMiner Agent aggregated events, operating hours and anomalies through natural-language requests

‍

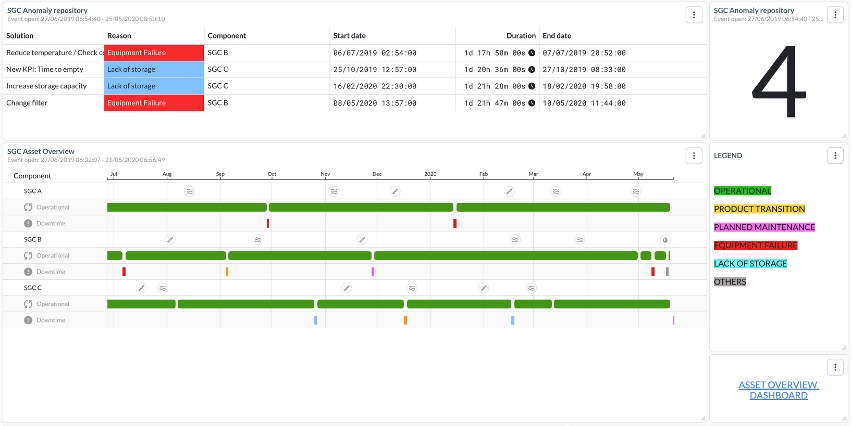

Gantt chart and overview dashboard with state detection and complementary plant information

‍

Key Insight

Converting process signals into defined operating states created a clear real-time overview, while AI enabled fast aggregation and analysis of operational events.

‍

Results

KPIResult
Operating state detectionModes automatically classified
Real-time visibilityGantt overview created
Event reportingEvents and operating hours summarized
Anomaly trackingDeviations quantified by period
Analysis capabilityNatural-language AI analysis enabled

‍

Value

By automatically detecting and summarizing operating states, the team improved operational visibility, simplified recurring reporting and enabled faster analysis of generation events and anomalies.

‍

Energy & natural resources
Reporting Compliance & Safety
Operational Performance Management
Production Reporting
Process Health Monitoring
Process Engineer
Plant Manager
Operator
Automation Engineer
Share with a co-worker
